Products / Industrial Products / Industrial Automation Enclosures
Industrial Products

Industrial Automation Enclosures: Sheet Metal Cabinets for Control Systems

SKU: FL-IN-021

Sheet metal enclosures built around your automation layout — PLC and drive cabinets, HMI stations and machine-mounted control boxes, from one-off prototypes to whole line builds.

MaterialCold-rolled steel (SPCC 1.5-2.0mm), galvanised steel, SUS304 / SUS316L, 5052 aluminium
Manufacturing ProcessLaser cutting + CNC bending + welding + powder coating
Surface FinishPowder coating (RAL 7035 / 7032 / 9005, or to sample)
Sheet Thickness1.0-3.0mm; internal frame members up to 4.0mm
Tolerance±0.3mm on cut and formed features
DimensionsCustom. Typical floor-standing 600×800×2000mm; wall or machine mounted from 300×400×150mm
IP ratingIP54 as standard; IP65 with gasketed doors and sealed apertures
DoorsSingle or double, with or without viewing window
Internal fittingsMounting plate, DIN rail brackets, gland plate, earth stud
Cable entryBottom, top or rear, through removable gland plates
MOQ20 units (single units accepted for prototypes)
Lead Time25-30 days after drawing approval
Sample Time15-20 days
ApplicationsPLC and control cabinets, drive cabinets, robot controller housings, HMI stations, junction boxes
ComplianceFabricated to the dimensional and material requirements of IEC 62208. Type testing and certification remain with the equipment builder or a third-party test house.

What Counts as an Industrial Automation Enclosure

An automation enclosure is not a single product. It is whatever sheet metal shell the control system needs: the cabinet that holds the PLC and its I/O, the one that holds the drives, the operator station on the machine, the junction box at the end of the line. What they share is that the internal envelope, the apertures and the cable entry are all decided by somebody else’s electrical design — which is why the drawing review matters more here than on a general-purpose enclosure.

What we buildTypical useWhat the enclosure has to get right
PLC and control cabinetsLine control, I/O racks, safety relaysMounting plate area, DIN rail spacing and the depth needed behind the door for wiring bends
Drive and inverter cabinetsMotor drives, servo amplifiers, soft startersHeat rejection and cable separation between power and signal wiring
Robot controller housingsCell-side controllers and teach pendants storageRigidity, because the unit is often moved or re-sited with the cell
HMI and operator stationsPanel-mounted screens and pushbutton clustersCut-out accuracy, viewing angle and access from the operator side
Machine-mounted control boxesControl boxes bolted onto the machine frameMounting interface and stiffness, so the box does not drum or twist
Junction and terminal boxesField wiring, sensor and actuator marshallingGland plate layout, entry direction and terminal rail fixing

How an Automation Enclosure Is Fabricated and Checked

The stages below are the same for one cabinet or a line build of forty. What changes with volume is the tooling, not the sequence.

StageWhat happensWhat is verified before the job moves on
Drawing reviewComponent layout, aperture schedule and cable entry are checked against the shell geometryWhether every component actually fits inside the internal envelope with room for wiring bends and clearance distances
Shell formingBody, doors, mounting plate and gland plates cut and formedThe internal clear dimensions and the mounting plate fixing pattern, which decide whether the components will fit on site
Cut-outs and aperturesHMI, gland, fan, filter and cable entries madeAperture position, size and burr condition. A burr left at a gland plate damages cable insulation during installation
Frame and seam weldingCorner seams and the door frame welded, with reinforcement where the weight sitsDiagonals across the door opening, and the door frame checked for twist before hinges are fitted
Door, hinge and gasketHinges, lock, handle and sealing gasket fittedDoor alignment, gasket compression and lock engagement, checked with the door closed on the finished gasket
Surface preparation and coatingDegrease, phosphate, then powder coat with masking at earth studs and gland areasFilm thickness, coverage inside corners, and that the masked areas are genuinely clear of coating
Assembly and continuityMounting plate, cable management, door stay and hardware fittedContinuity between door and body through the bonding strap, plus hardware torque
PackingDoors braced, unit wrapped, corners and edges protectedThe packed unit against the packing specification. The door and its hinges are the vulnerable part in transit
Corner seams being welded on a sheet metal cabinet frame
Corner seams welded on a cabinet frame. The door opening is checked for square before hinges are fitted — a frame that is out of square will not seal, however good the gasket is.

Six Decisions That Decide Whether the Cabinet Works on Site

Most automation enclosure problems we are asked to fix are not manufacturing faults. They are decisions that were never made at drawing stage, and then had to be solved on site with a drill.

DecisionWhy it mattersWhat we need from you
How the heat leavesDrive cabinets reject far more heat than PLC cabinets. A sealed IP65 cabinet holding drives will overheat unless the heat path is designed in from the startThe total dissipation in watts, and whether filtered fans, a louvred vent panel or a heat exchanger is acceptable in the environment
Where cables enterCable entry drives the gland plate layout, the frame reinforcement and whether the cabinet can be pushed back against a wallEntry face (top, bottom, rear), the number and size of glands, and whether screen bonding is needed at the entry point
Depth behind the doorWiring needs bending room. Cabinets that are dimensionally correct but too shallow are the most common rework we seeTerminal block depth, wire duct size and the minimum bend radius the wiring spec allows
Protection ratingThe rating changes the gasket, the door stiffness and how every aperture is treated — not the sheet thicknessThe IP rating the site actually requires, and whether washdown or hose-directed water is involved
Earthing and bondingCoating between the bonding point and the frame is a continuity fault that only shows up at commissioningWhether the bonding points are on the mounting plate, the door or both, and whether the site requires a dedicated earth bar
Line and batch consistencyOn a line build, cabinets stand next to each other. Different plinth heights or cable trunking positions look like a mistake even when each unit is within toleranceThe full cabinet schedule, so shared dimensions such as plinth height and trunking centre lines can be fixed across the batch

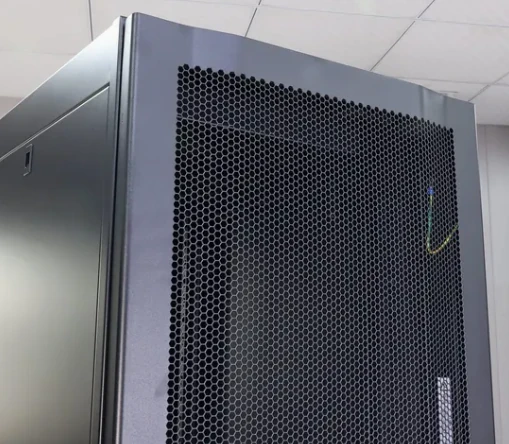

Perforated vent panel fitted to an enclosure side
A perforated vent panel. The open area, the aperture pattern and the burr condition are all fixed before coating — the vent cannot be reworked once the powder is on.

What Can Be Changed Without New Tooling

Customisation is mostly about the internal envelope and the apertures, because those are what the electrical design depends on.

What can be changedWhat it affectsWhat it does not affect
External dimensions and internal depthPanel sizes, mounting plate size and the packingThe protection concept, as long as the gasket and door design stay the same
Single or double doorHinge count, lock type and the swing clearance needed on siteThe internal mounting plate
Mounting plate type and hole patternComponent layout and fixing positionsThe shell
Aperture scheduleHMI cut-outs, gland plates, fan and filter openingsThe frame, within the limits of the panel width
Protection ratingGasket specification, door stiffness and how apertures are treatedThe external dimensions
Cable entry face and layoutGland plate position and the cut-outs behind itThe frame
Colour, finish and markingPowder specification, labelling and identification platesNothing structural

Checks We Run on Every Batch

  • Dimensional — outside dimensions, door opening diagonals and mounting plate fixing centres against the approved drawing.
  • Fit — hinges, lock and gasket checked with the door closed on the finished gasket, not on a bare frame.
  • Coating — film thickness and coverage, with the masked bonding and gland areas confirmed clear of powder.
  • Continuity — bond resistance between door and body through the earth strap, recorded per unit.
  • Apertures — each cut-out checked against the aperture schedule before the unit is packed.
  • Packing — door braced, unit wrapped, corners protected, and the pallet marked for the destination.
Operator checking a formed enclosure panel at the press brake
Formed panels checked at the press brake against the forming drawing, before the batch is released to welding.

Standards: What We Build To, and What We Do Not Certify

We are the sheet metal fabricator, not the equipment manufacturer. Our scope covers the enclosure as a mechanical part: the material, the sheet thickness, the forming and welding, the coating and the dimensional accuracy.

Where a standard governs the enclosure itself — for example IEC 62208 for empty enclosures — we fabricate the shell to that standard’s dimensional, material and coating requirements. The certification of the finished assembly, and any type test of the enclosure as part of an electrical product, is carried out by the equipment builder or a third-party test house, because the result depends on the components installed, the wiring and the final assembly, none of which are within our scope.

If your project needs a specific declaration or test evidence, say so at enquiry stage and we will tell you what we can supply from our side and what has to sit with you.

Frequently Asked Questions

What is the difference between an automation enclosure and a control panel enclosure?

An automation enclosure is the container for a control system — it may hold a PLC, drives, safety relays and the field wiring all at once, and it is usually sized around a cabinet schedule rather than a single component. A control panel enclosure is typically one panel with an HMI or pushbutton cluster. In practice the two overlap, and we build both. If your project is a single panel rather than a system cabinet, see industrial control panel enclosures.

Can you build a line where every cabinet is a different size?

Yes, and this is where a fabricator with its own drawing review earns its keep. Send the whole cabinet schedule at once rather than the cabinets one at a time. Shared dimensions — plinth height, cable trunking centre line, door swing direction, lock type — should be fixed across the batch so the units still line up when they are bolted together on site.

How does heat get out of a sealed cabinet?

It has to be designed in. A sealed IP65 enclosure rejects heat only through its surfaces, which is rarely enough for a drive cabinet. The usual options are a filtered fan with a louvred outlet, a vent panel with a defined open area, or a heat exchanger that keeps the internal air separate from the plant air. What matters is that the open area and the fan position are decided at drawing stage, because a vent cannot be added cleanly once the panel is coated.

Will you supply one unit before we commit to a batch?

Yes. A single unit is the cheapest way to prove the internal envelope, the aperture positions and the door operation against the real components. It takes 15–20 days, and the forming programme carries over to the batch, so the prototype is not wasted work.

What do you need from us to quote?

The enclosure drawing or a dimensioned sketch; the component layout if it is fixed; the aperture schedule; the cable entry face and gland sizes; the material and IP rating; the colour; and the quantity and delivery date. If the drawing is not final, send what exists — the review is more useful before the drawing is frozen than after. Send it through the RFQ form.

Related reading: automation equipment sheet metal fabrication, control cabinet manufacturing process, enclosure assembly service and custom metal enclosure manufacturing.
